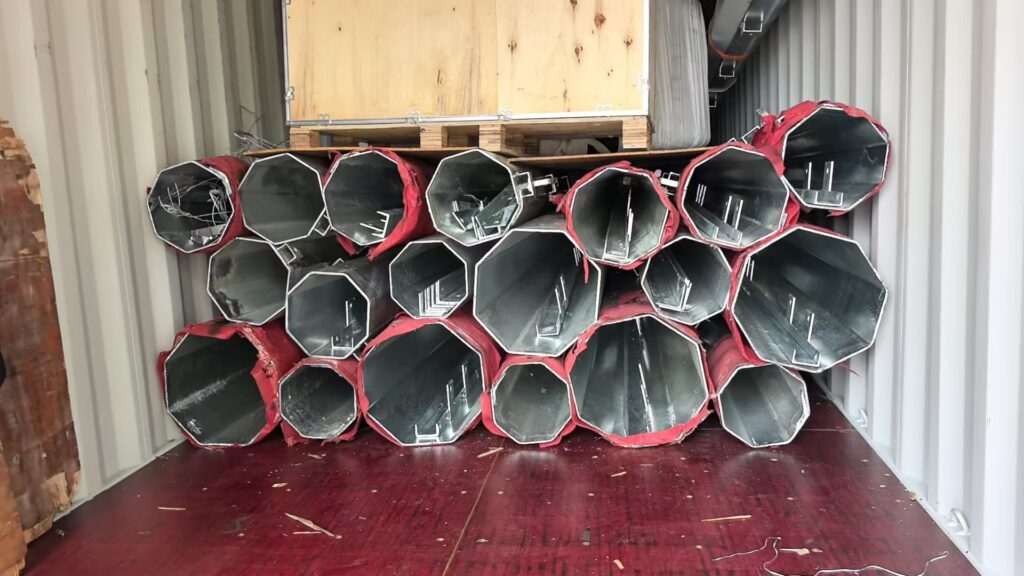

Galvanized octagonal steel poles packed inside a container for the Burundi overhead line project
Industry Solutions

Export Packing and Logistics for Overhead Line Projects in Landlocked African Markets

Younxin Engineering Team · · Updated: August 6, 2026 · 6 min read · 1,048 words

For a landlocked power project, delivery does not end when the container reaches the seaport. Equipment must pass through port handling, customs, inland transit and final site unloading before installation can begin.

This is especially demanding for an overhead distribution package containing long steel poles, crossarms, fragile insulators, heavy transformer equipment and hundreds of small fittings.

For a Burundi overhead line supply project, the planned route used an East African gateway port followed by inland delivery. The project illustrates how engineering, packing and logistics should be planned together from the beginning.

Why mixed power-equipment cargo is difficult to pack

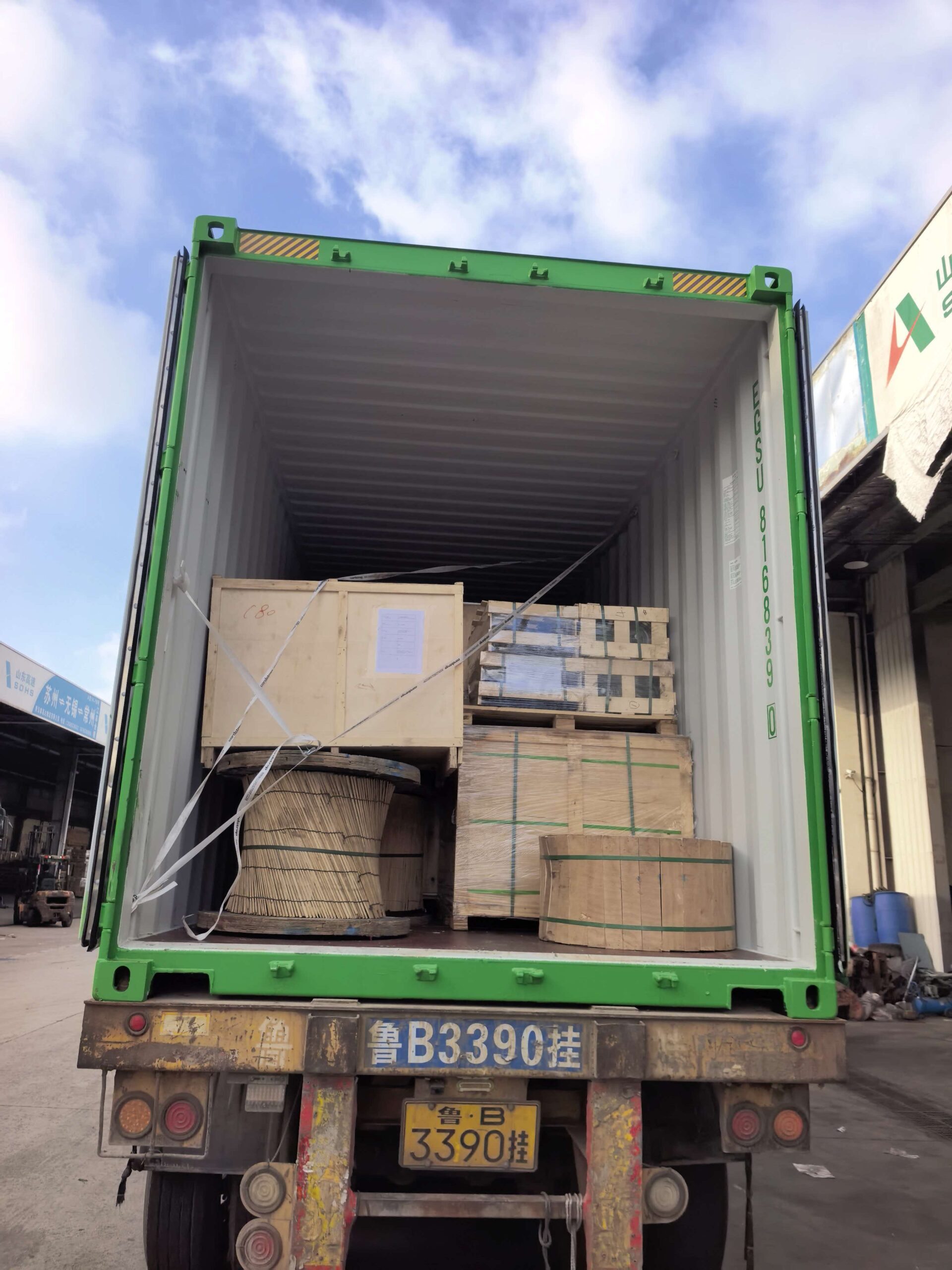

Electrical equipment crates and conductor drum secured inside a container for shipment to Burundi
Actual container loading for the Burundi overhead line project: packed equipment crates, conductor drum and project materials secured for export.

A complete line package contains items with very different physical characteristics:

  • long galvanized steel poles;
  • crossarms, braces and mounting plates;
  • glass or porcelain insulators;
  • conductor drums and cables;
  • isolators, fuse cutouts and surge arresters;
  • transformer and LV distribution equipment;
  • earth rods, flat steel and connectors;
  • bolts, pins, clamps and other small fittings.

The largest risk is not only damage. It is losing the relationship between a part and its installation position.

A box of bolts may look minor at the factory, but if it is not marked against the correct pole structure, the site team may spend days sorting components.

Build the packing plan from the BOM and pole schedule

Each package should have a unique number linked to:

  • BOM item number;
  • English product name;
  • quantity;
  • gross and net weight;
  • dimensions;
  • project or structure reference;
  • destination and consignee marks where authorized.

For pole-line hardware, an even better method is to create installation sets. For example:

  • tangent pole set;
  • angle pole set;
  • terminal pole set;
  • transformer pole equipment set;
  • guard-wire anchoring set;
  • earthing set.

This reduces the amount of sorting required at site.

Protect galvanized steel during container transport

Galvanized poles and crossarms are durable in service, but their surfaces can still be damaged in transit.

Packing should prevent:

  • unprotected metal-to-metal rubbing;
  • movement during braking and sea motion;
  • water accumulation inside bundled sections;
  • contact between galvanized steel and incompatible metals;
  • forklift or sling damage at lifting points.

Use suitable separators, secure bundles at calculated points and mark lifting positions. Small galvanized accessories should be packed dry and protected from loose movement.

Give fragile electrical equipment its own protection strategy

Glass insulators, fuse cutouts, surge arresters and instrument components should not be packed as ordinary steel hardware.

Recommended controls include:

  • individual cushioning or separated cells;
  • rigid outer cases where required;
  • clear orientation and fragile markings;
  • moisture protection;
  • accessory bags fixed inside the same case;
  • pre-packing inspection photographs.

For fuse cutouts, confirm that fuse links and small mounting components are listed and packed. For gang-operated isolators, keep phase units, linkage, operating rods and mounting brackets clearly associated.

Container planning should happen before production finishes

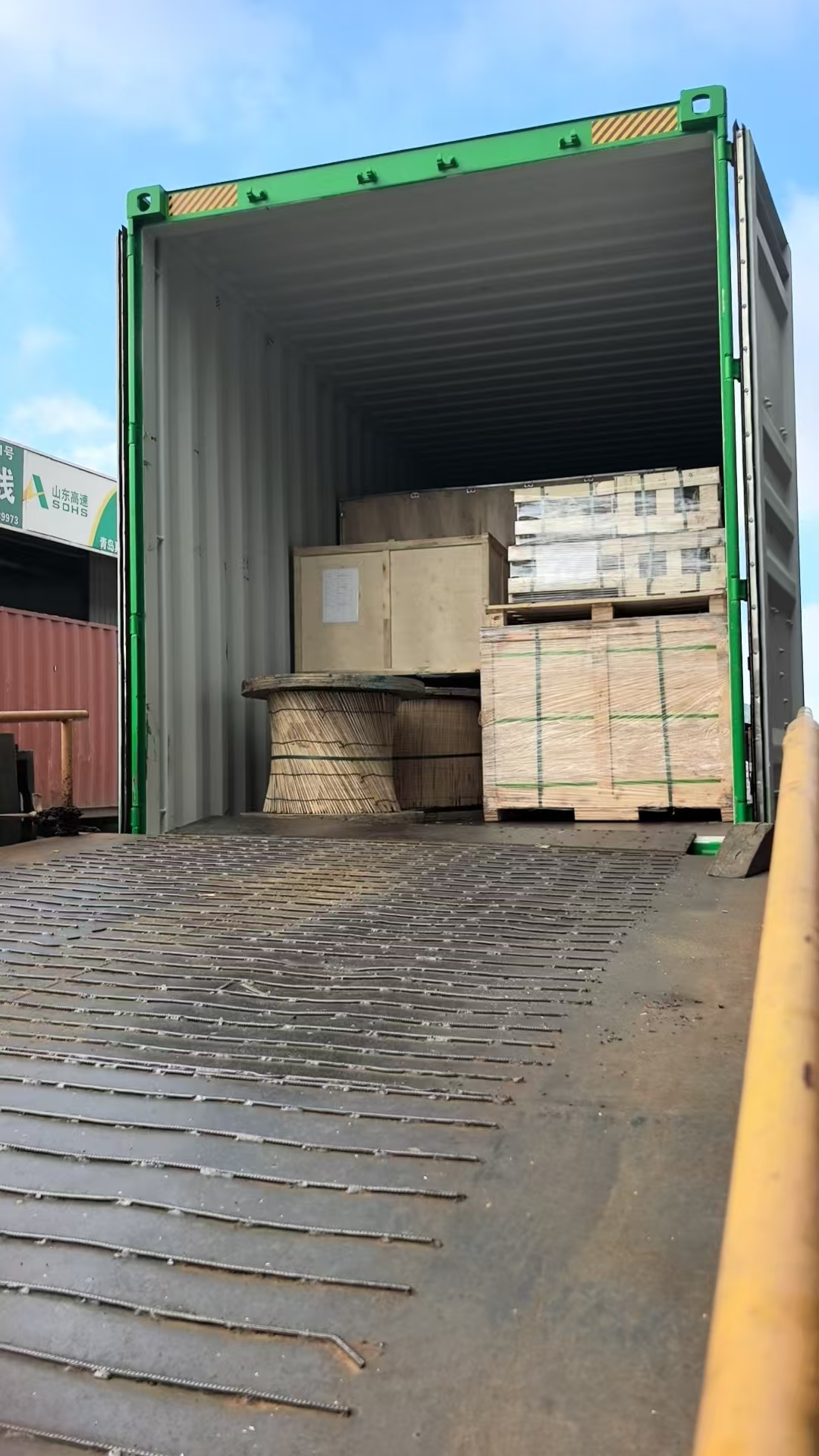

Burundi overhead line equipment container loading in progress at the factory
Container loading in progress before the remaining project packages were positioned and secured.

Waiting until every item reaches the warehouse can lead to expensive changes. The logistics team should estimate volume and loading constraints while technical drawings are still being finalized.

Need equipment matched to your project?

Get a Quote →

Important inputs include:

  • pole segment length and bundle dimensions;
  • conductor-drum diameter and weight;
  • transformer lifting and center-of-gravity data;
  • crate stackability;
  • container door dimensions and payload;
  • unloading equipment available at destination;
  • whether oversized items require special handling.

The goal is not simply to fill every empty space. Heavy cargo must be distributed safely, and fragile packages must not carry unintended loads.

Plan for port-to-inland movement

When cargo moves from a gateway port to a landlocked destination, review:

  • transit customs documentation;
  • container free time and potential demurrage;
  • road restrictions for long or heavy cargo;
  • border procedures;
  • availability of crane, forklift and low-bed transport;
  • final-mile road and site access;
  • return requirements for the shipping container.

The commercial term on the quotation should state clearly where the supplier's cost and responsibility end. FOB, CIF and delivered terms create different obligations. The inland route should not be assumed to be included simply because the final project country appears on the documents.

Documents should match the physical cargo

A strong export document package may include:

  • commercial invoice;
  • packing list;
  • bill of lading instructions;
  • certificate of origin where required;
  • product data sheets;
  • drawings and approved technical schedules;
  • test reports and certificates;
  • packing photographs;
  • serial-number or nameplate records;
  • fumigation or wood-packaging documents where applicable.

Descriptions, quantities and weights should be consistent across the invoice, packing list and shipping documents. Last-minute wording changes can delay customs review.

Do not ship restricted items without route confirmation

Some project consumables may be difficult or prohibited to move through ordinary domestic and international cargo channels. Pressurized gas cylinders, flammable products and certain chemicals require special handling.

If a low-value restricted item can be sourced reliably near the project, local purchase may be safer and more economical. Any exclusion should be stated clearly in the quotation and final supply list.

Use packing photos as part of technical communication

Packing photographs should demonstrate completeness, not create new uncertainty. A useful photo record includes:

  1. the complete product;
  2. its nameplate or identifying feature;
  3. all accessories laid out together;
  4. the packing process;
  5. the closed package and shipping mark;
  6. the package position inside the container.

This record helps the buyer verify the shipment and supports the site team if a package is not immediately identifiable.

One coordinator for equipment, packing and documents

Mixed-BOM overhead line projects benefit from one consolidated packing plan and one controlled document set. This does not remove the need for specialist factories, but it reduces gaps between suppliers.

Younxin supports project buyers with BOM consolidation, technical matching, packing-list preparation, export packing and shipment coordination for African power projects.

Send your equipment list, destination port, final project location and required delivery term. We can help prepare a supply and packing plan before quotation.

FAQ

Can long steel poles be shipped in a standard container?

It depends on the final segment length, bundle dimensions and container limits. Pole design and logistics planning should be coordinated early.

Should hardware be packed by product type or pole structure?

For installation efficiency, structure-based sets are often preferable, while the master packing list should still retain each BOM item and quantity.

Why are pre-shipment photos important?

They help verify completeness, connect accessories with the main equipment and provide a reference for customs, receiving and site installation teams.

Younxin Engineering Team

Power Systems Engineering & Procurement Team

15+ years of project sourcing and OEM/ODM experience across transmission, distribution, substations, cable systems and power equipment.
